Commercial
& Industrial |
Ferguson Enterprises Building at 6002 42nd Street | ||
Date | Site Photos | Details |
Scrapping the site - SE | ||
|
||
Day of the 4"-6" snow | ||

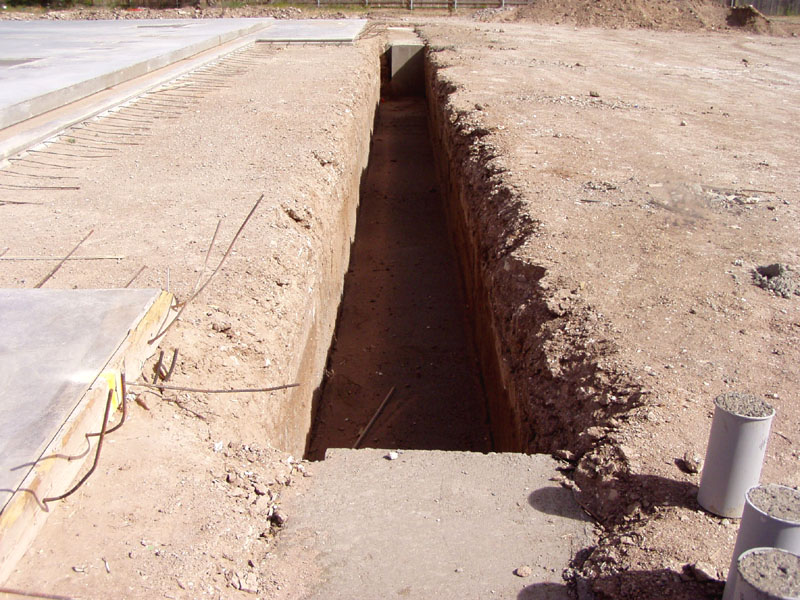

Day after the snow | ||
Finished with the building pad | ||
Rain delay - still raining on the 15th | ||
Trying to dry up 6.73" for the month of November. | ||
|
||
Perimeter leave-out slab forms set | ||
Coming Soon sign placed | ||
Trenching for water & sewer | Butler Steel arrives | |
Misc. steel & joists | Misc. steel & roof panels | |
Looking NE | Tying rebar for slab | |
Looking NW | Close-up of rebar mats | |
Plumbing rough-in | ||
Footing bearing tested out at over 4000 psf! | Digging column footings | |
Silt screen for SWPPP compliance | Preparing main column footings | |
Site grading | Main column footing with block out | |
Preparing stub ups for slab | Beginning rebar layout for slab | |
Slab rebar in place | Stub ups ready for slab pour | |
Rebar through forms at pour strip | ||
Pouring the slab starting at midnight Sunday | ||
Finishing the slab on Monday | ||
Saw cutting and covering the slab Monday night | ||
Finished covered slab | ||
|
||
Rain delay through the 6th | ||
Rain delay through the 31st | ||
|
||
Snow delay | ||
Rain delay through the 12th | ||
Forms for panels in place | ||
Panel at main entry | ||
Detail at window/door corners | ||
Rain delay through the 21st | ||
Working on Sewer down future 42nd Street | ||
Setting the Fire Sprinkler Main on the North | ||
Setting rebar, anchors, weld plates, & lifting inserts | ||
Rain delay through the 27th | ||
|
||
Rain delay through the 6th | ||
Finished with the panels, ready to pour concrete. | ||
Finished sewer lines, put in fire hydrants, staked c&g. | ||

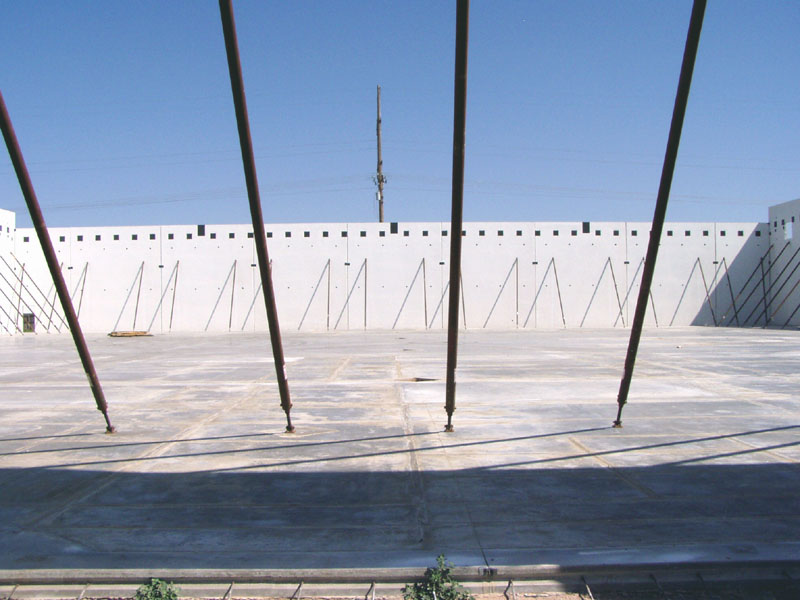

Pouring and finishing the tilt-wall panels. | ||
Snow delay - 2" | ||
Perimeter Footings excavated and rebar installed | ||
|
||
Perimeter Footings & HVAC slab poured | ||
Finishing up installing water taps | ||
Past 2 days, winds have hit 55mph! | ||
First day of tilting panels | ||
Second day of tilting panels | ||
Last day of tilting panels | ||
East wall primed for paint | Priming West wall | |
Priming mezzanine structure | Preparing to pour leave out strip | |
Building structure looking SW | Building structure looking SE | |
Attaching building structure to South wall | Detail at main beam | |
Detail at end of joist | Detail at building corner | |
|
||
Rain delay through the 7th | ||
Exterior Painting | ||
Interior Structural | ||
Electrical Service installed | ||
Rain - 1.30" | ||
Grading Site | ||
Trenching utilities to building | ||

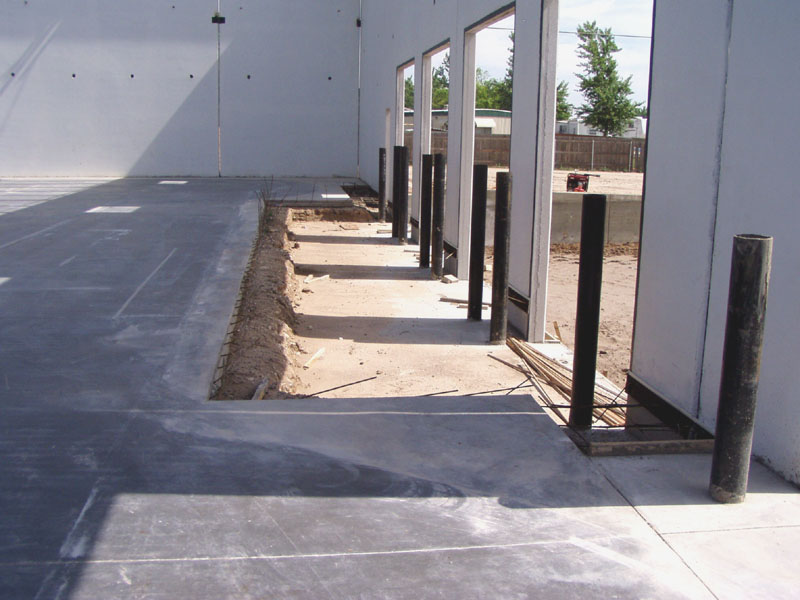

Beginning roofing & pouring slab leave out | ||
Rain delay | ||
|
||
Window framing being installed | ||
Misc. concrete details | ||
Truck well side walls poured and gas stub up | ||
Rain delay | ||
Installing Ext. Glass | ||

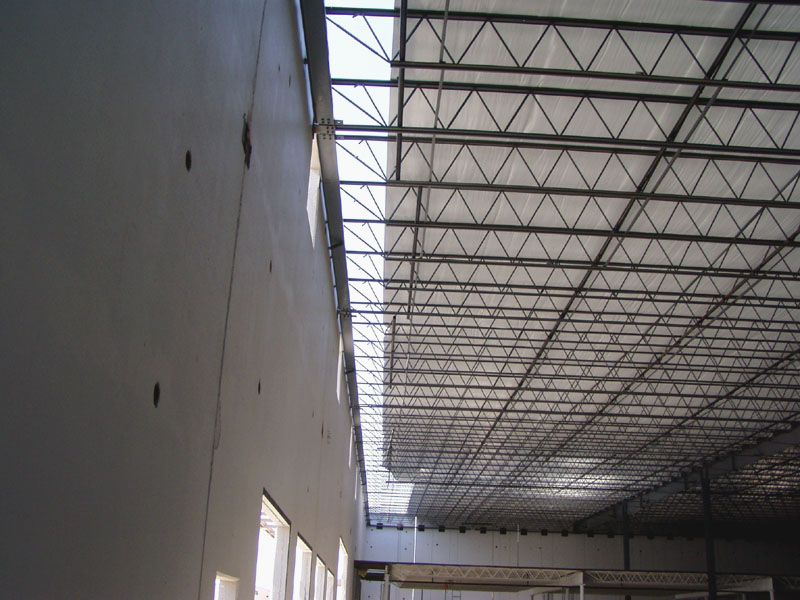

Mezzanine struct & office framing started, roof halfway | ||
Mech. dock leveler details & ready for truck well slab | ||
Dock canopies and NW stoop installed | ||
Rain delay | ||
Exterior Views | ||
Placing Bollards and Light standards | ||
Setting North fencing and Pouring concrete truck yard | ||
Roofing and setting fire sprinkler pipe | ||
Stud Framing and Structural | ||
Poured East parking lot | ||
Light pole base and dock levelers in place | ||
Continued framing and structural | ||
Setting fire sprinkler pipe & restroom plumbing | ||
Electrical panels in place & beginning stair construction | ||
Poured South parking lot | ||
Framing & Structural for mezzanine | ||

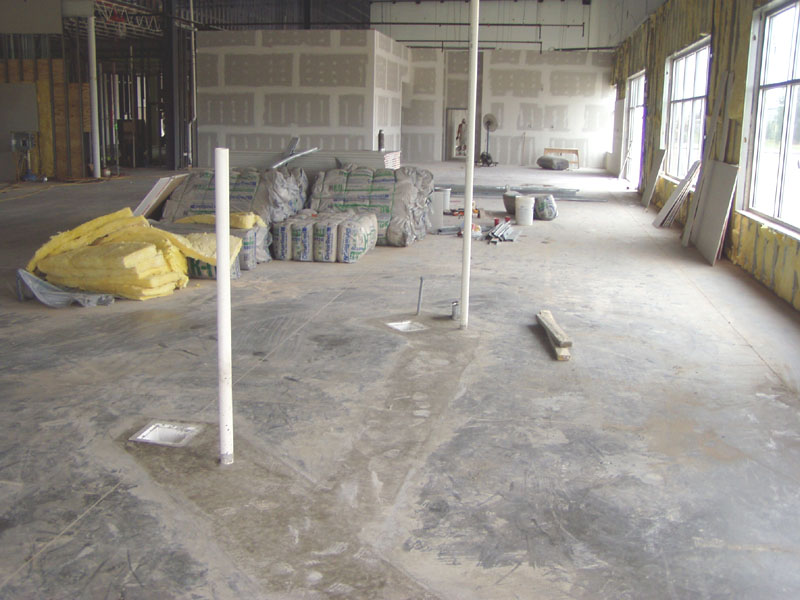

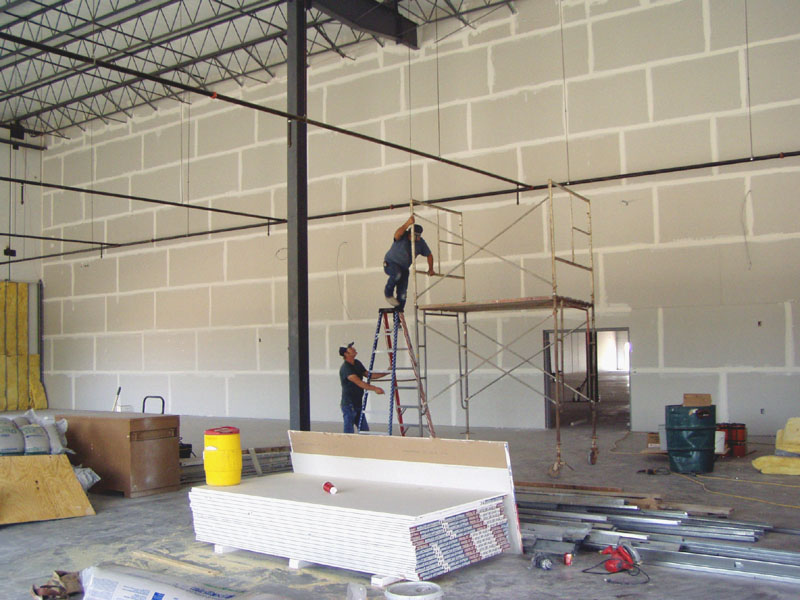

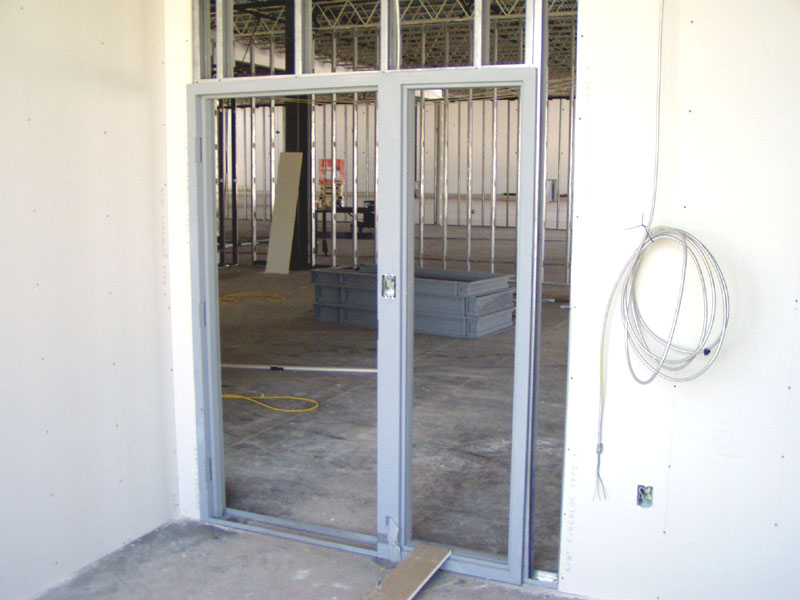

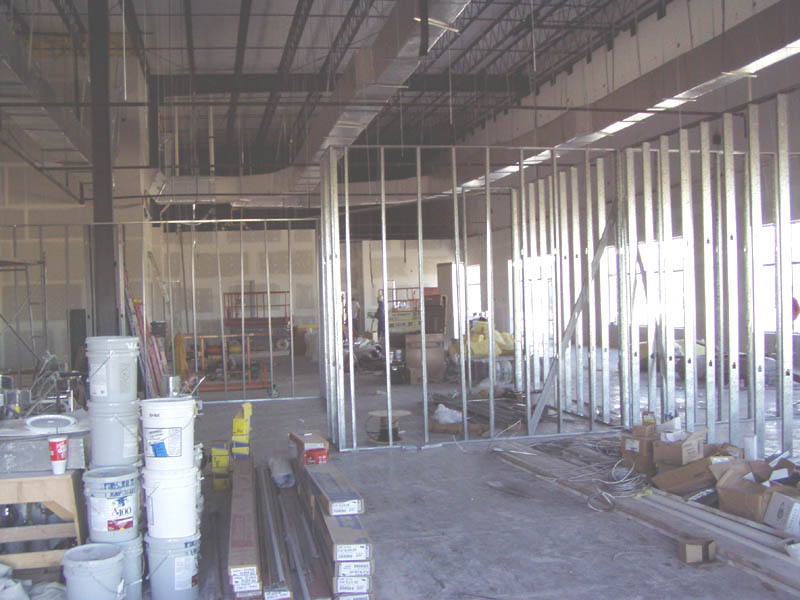

Begin hanging drywall in offices | ||
Begin hanging drywall in offices | ||
Plumbing & Trenching | ||
Poured sidewalk in front of building | ||
Poured concrete on mezzanine | ||
Continued hanging drywall in offices | ||
Continued hanging drywall in offices | ||
Continued hanging drywall in offices | ||
Plumbing, electrical, & overhead doors installed | ||
|
||
Finished drives & parking lots | ||
Hanging drywall in Showroom | ||
Finishing drywall in offices & Express Parts | ||
Mezzanine railing and wall to deck | ||
Warehouse area | ||
Site work & road construction | ||

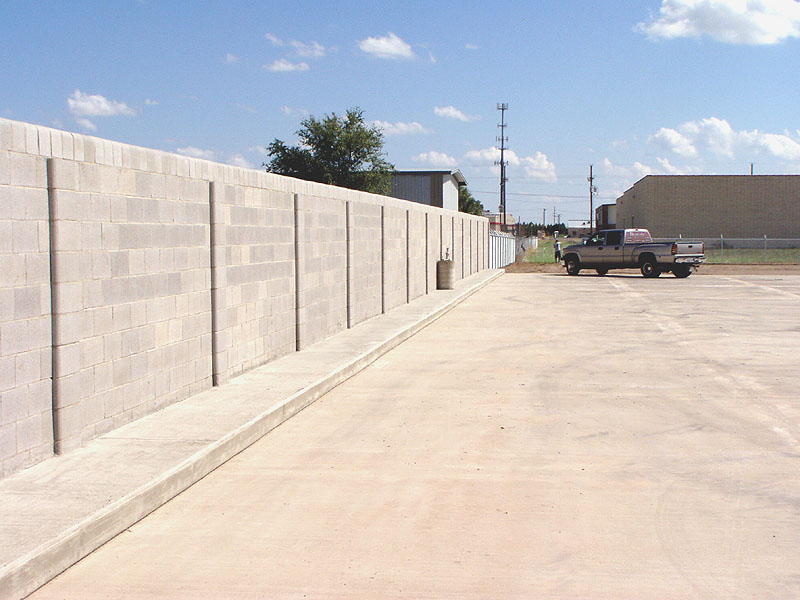

CMU fence & exterior building details | ||
Finish out in offices & Express Parts | ||
Preparing to install HVAC components | ||
Louver vents & fire sprinkler system | ||
Exterior building, new street, offices, & showroom | ||
Express Parts | ||
Mezzanine & warehouse | ||
Exterior Panorama | ||
Finishing offices | ||
Showroom & Express Parts | ||
Warehouse | ||
|
||
Exterior views & site work | ||
Office & Express Parts | ||
Showroom | ||
Warehouse | ||
Exterior views & site work | ||
Office & Express Parts | ||
Showroom | ||
Mezzanine & warehouse | ||
Completion photos | ||
